Port St. Lucie Boulevard South Project

  • Project typeRoad Widening Project

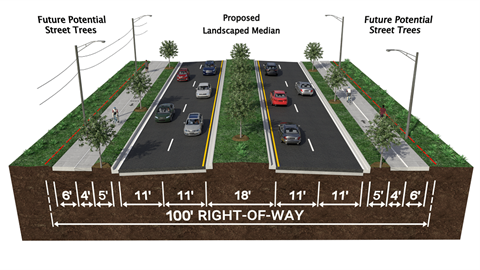

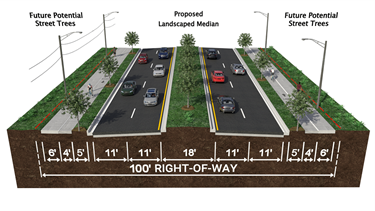

PSL Blvd South Typical

This project will expand the southern portion of Port St. Lucie Boulevard from a two-lane undivided roadway to a four-lane divided roadway to improve traffic flow and safety. The project also incorporates “complete street” elements to enhance mobility for pedestrians, bicyclists and vehicles.

Key Improvements

  • New signalized intersections at SW Alcantarra Boulevard, SW Tulip Boulevard and SW Tunis Boulevard.
  • Right turn lane addition on SW Port St. Lucie Boulevard's north approach to SW Alcantarra Boulevard.
  • Raised median construction (18-foot wide) with curb and gutter.
  • Upgraded crosswalks and curb ramps to meet ADA standards.
  • Expanded sidewalks (8 to 10-feet wide on both sides of SW Port St. Lucie Boulevard; 6-feet wide on side streets).
  • New closed drainage system for improved stormwater management.
  • Enhanced lighting, signage and pavement markings for better visibility and safety.
  • Landscaping with trees, irrigation and stamped concrete for a polished look.
  • New right turn lanes to Paar Drive.
  • New signaled intersection at Paar Drive and McCall Road.
  • Additional northbound left turn at Gatlin Boulevard.
  • Additional southbound turn at Darwin Boulevard.

Segments

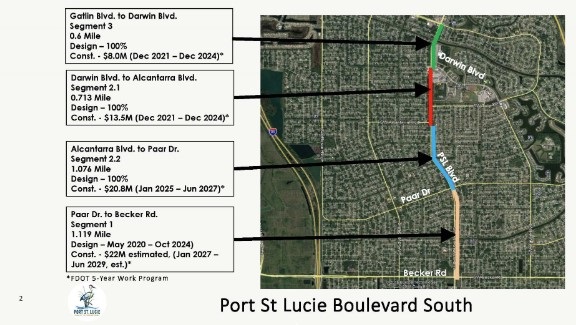

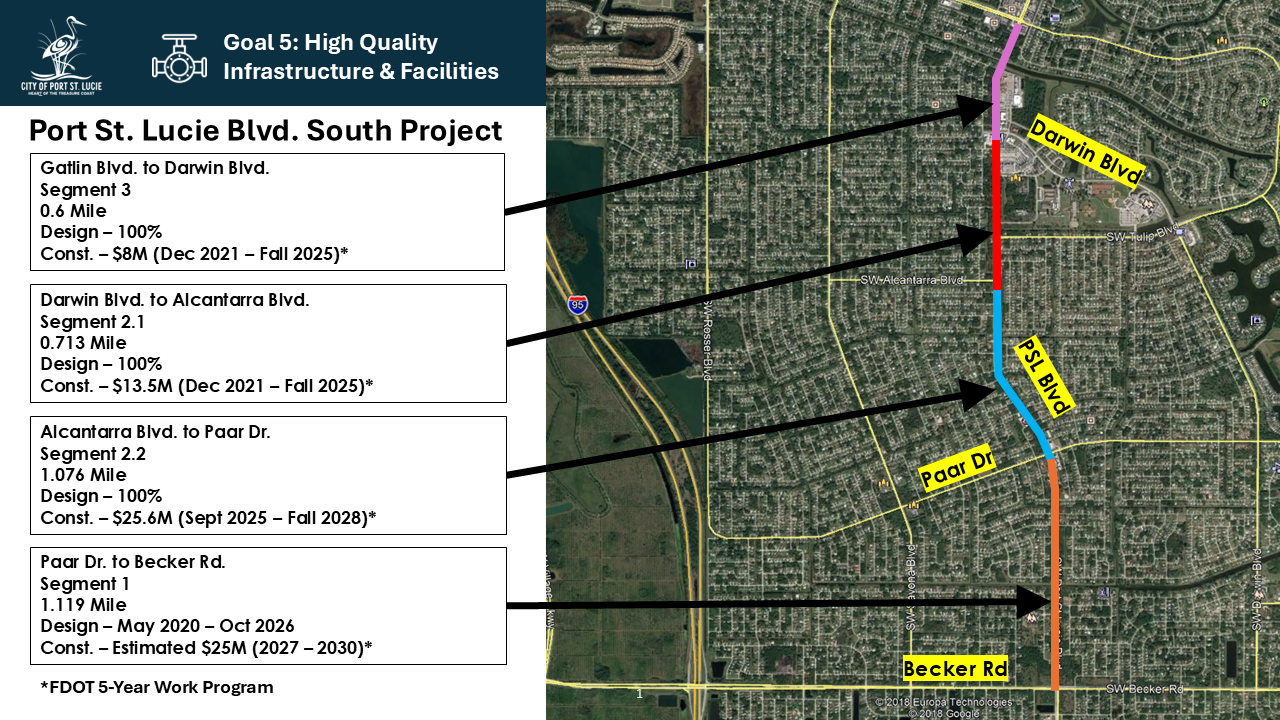

Segment 3: Gatlin Boulevard to Darwin Boulevard

Reconstructing 0.6 miles with upgraded turn lanes, drainage, medians, paths, lighting and utilities.

Segment 2.1: Darwin Boulevard to Alcantarra Boulevard

Widening 0.7 miles with new paths, signals, lighting, drainage and relocated utilities.

  • Status: Under Construction
  • Construction is managed by FDOT: Dec. 2021 – Winter 2025*
  • Contractor: Zahlene

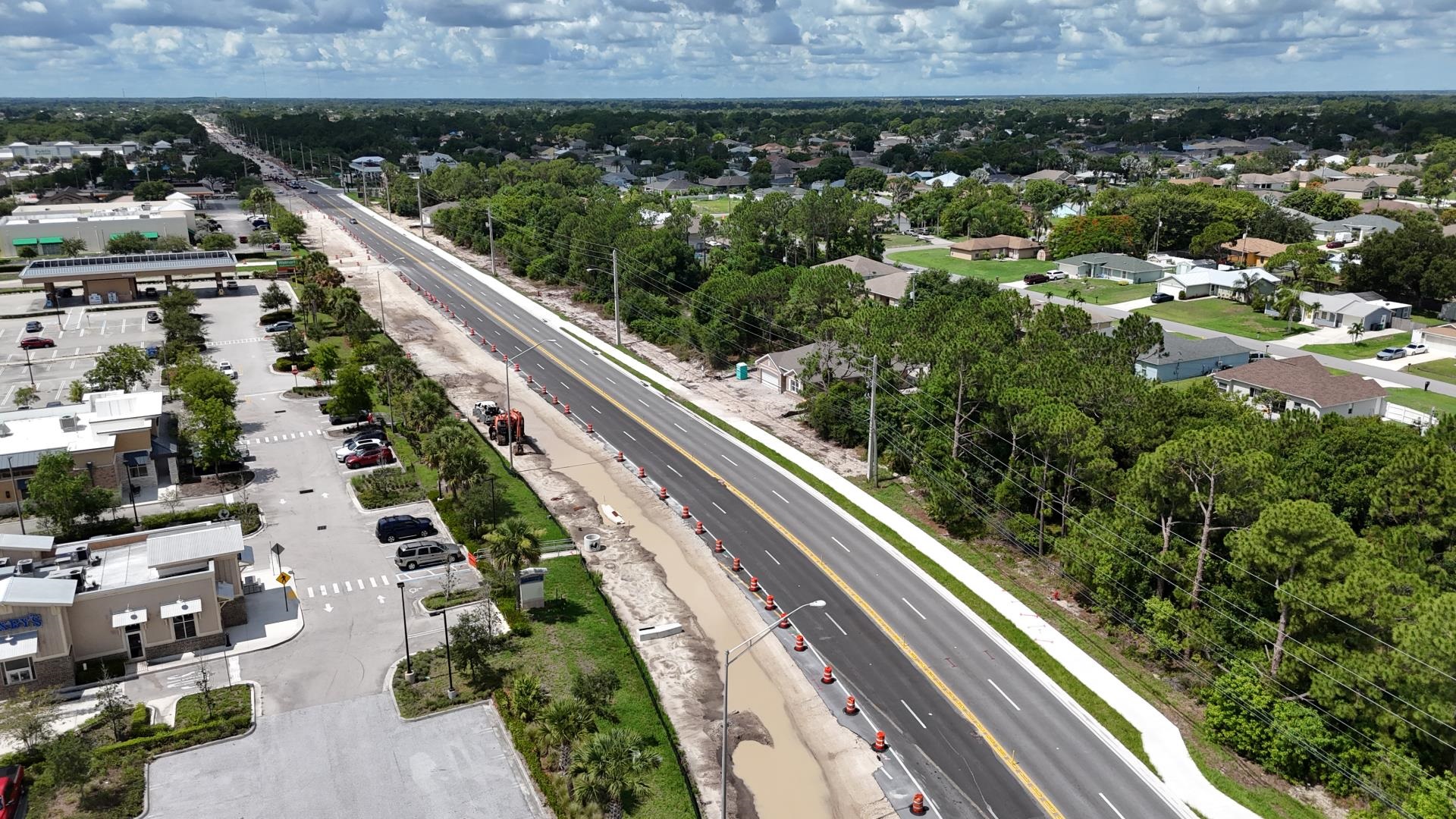

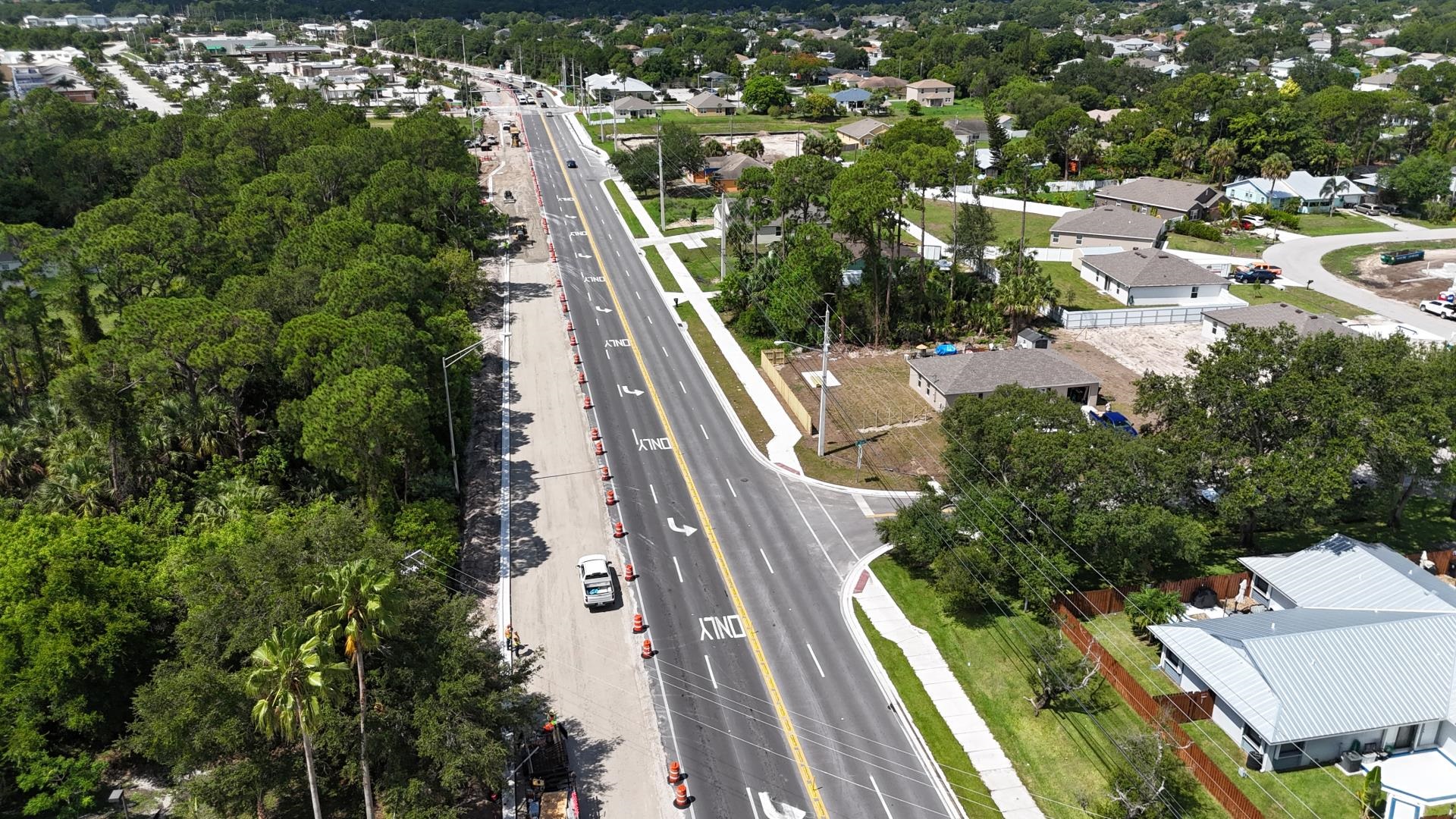

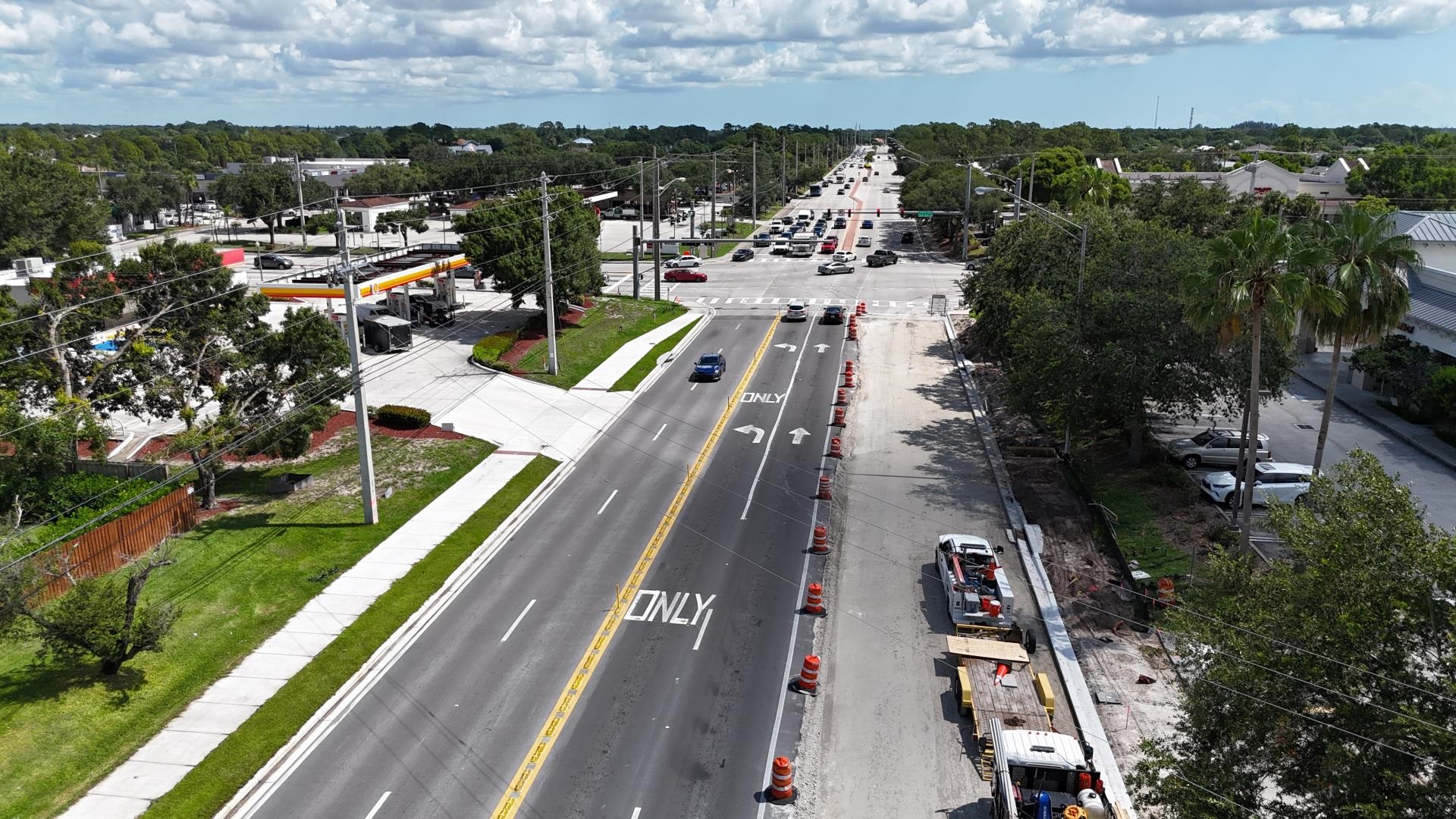

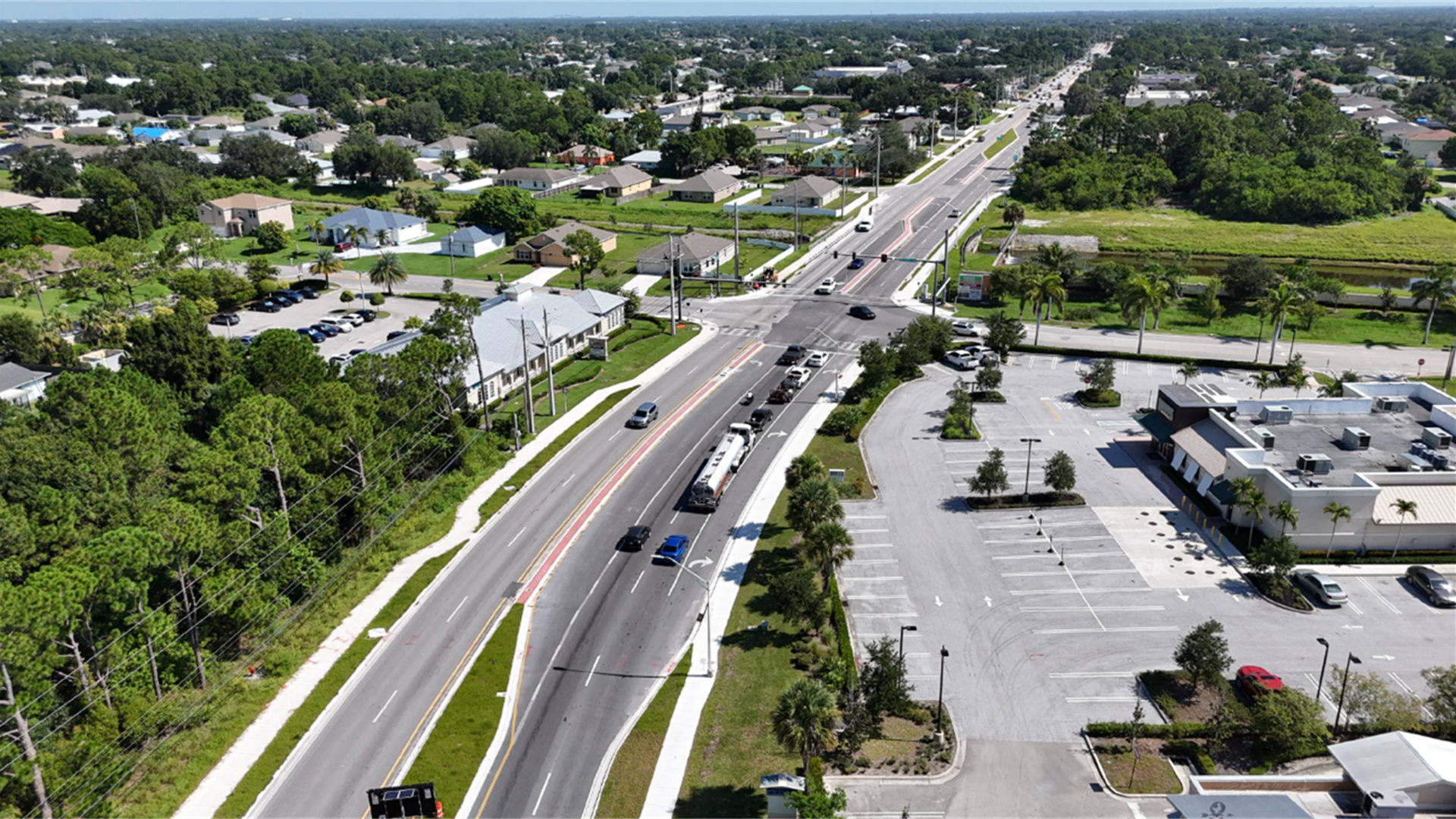

  • Current work: Watermain installation, drainage delivery and clearing
  • Lane closures: Intermittent closures on Port St. Lucie Boulevard & Trouville Avenue (8 a.m. to 3 p.m.)
  • Contact: Samantha Kayser, Community Outreach Specialist at 772-579-5479 or skayser@corradino.com
  • Visit FDOT Project Webpage
  • Segment 2.1 Map

Segment 2.2: Alcantarra Boulevard to Paar Drive

Widening approximately 1 mile with new paths, signals, lighting, drainage and relocated utilities.

Segment 1: Paar Drive to Becker Road

Widening approximately 1 mile from two to four lanes, with multi-use paths, landscaped medians, updated signals, drainage and utility relocation.

  • Status: In Design (May 2020 – Oct. 2026)
  • Construction is managed by FDOT: Estimated 2027–2030*
  • Funding: Unfunded; estimated $25 million. The City is partnering with FDOT to expedite the project by providing upfront funding, with reimbursement to follow from FDOT.
  • Visit FDOT Project Webpage
  • Segment 1 Map(PDF, 865KB)

* FDOT 5-Year Work Program
